Getting Started with React Gantt Chart

This guide walks you through installing and rendering your first React Gantt Chart component. You’ll learn how to bind task data, map fields, and display a basic project schedule in just a few minutes.

Prerequisites

Install the Syncfusion CLI

Install the Syncfusion CLI globally using the following command:

npm install -g @syncfusion/syncfusion-cli

Set up the Vite project using Syncfusion CLI

You can create a React Vite application using the Syncfusion CLI. The CLI provides two ways to create a project:

Non-interactive mode

Non-interactive mode allows you to create a project directly using a single command with the required command-line arguments.

sf new my-gantt-app --framework react --type ts --template gantt --theme tailwind3

In this mode, the project configuration is passed directly in the command. The above command creates a React Vite application configured with the Syncfusion® Gantt Chart component.

Interactive mode

Interactive mode guides you through the project creation process with step-by-step prompts.

sf

When you run the sf command, the CLI prompts you to select the required project configuration. To create a React Vite application with the Syncfusion® Gantt Chart component, select the following options:

√ Project name? ... my-gantt-app
√ Choose Framework: » React
√ Choose Build Tool: » Vite
√ Choose Language: » TypeScript
√ Choose Template: » Gantt
√ Choose Theme: » Tailwind3
√ Choose Style Format: » CSS
√ Would you like to integrate the Syncfusion MCP Server (AI Assistant) into this project? ... no
√ Would you like to install Syncfusion Component Skills for AI-powered development? ... no
√ Install dependencies and start app now? ... no

The above selections generate a React Vite application configured with the Syncfusion® Gantt Chart component. You can choose different values for language, theme, style format, MCP setup, and skills installation based on your project requirements.

The Syncfusion® CLI creates the project with a predefined template. After the project is generated, you can customize or replace the component code based on your application requirements.

Run the project

Once the project is created, navigate to the project directory and run the following commands in your terminal.

cd my-gantt-app
npm install
npm run dev

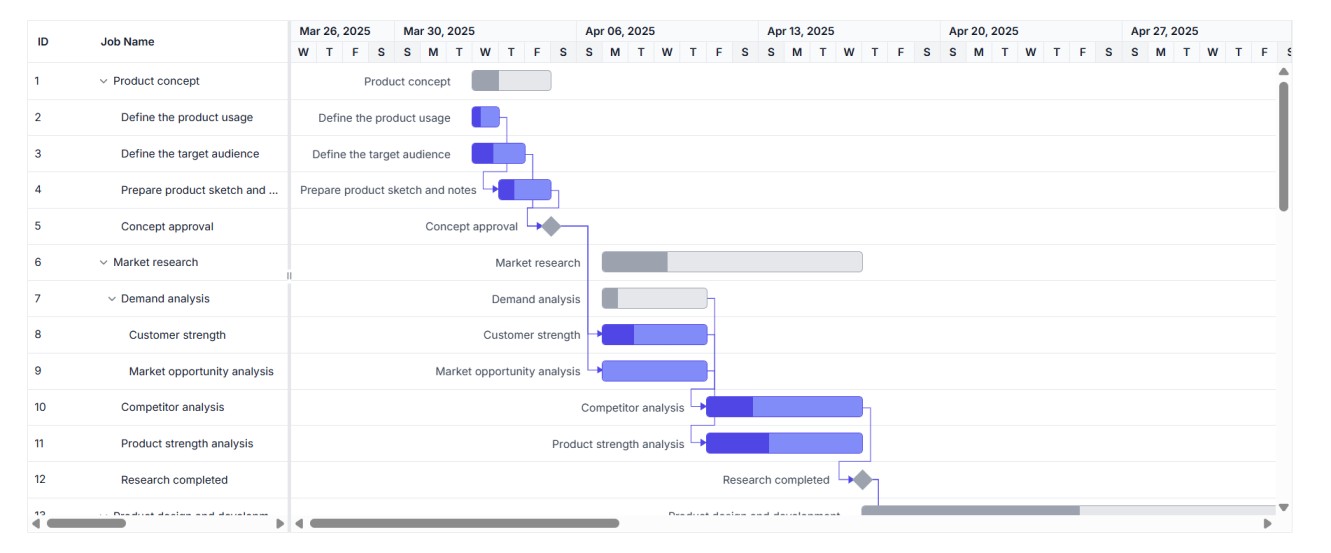

The output will appear as follows:

Gantt Chart Component

Prerequisites

Before you begin, ensure you have:

  • Node.js (v14.0 or later)
  • npm or yarn package manager
  • Basic knowledge of React (v18 or later recommended)

Installation

Create a new React app using Vite with TypeScript:

npm create vite@latest my-gantt-app -- --template react-ts
cd my-gantt-app

Use --template react for JavaScript instead of TypeScript.

Install the Gantt Chart package:

npm install @syncfusion/ej2-react-gantt

To install a specific version (for matching an internal version pin), use npm install @syncfusion/ej2-react-gantt@<version>. The ej2-base and other dependent @syncfusion/ej2-* packages are installed transitively.

If you created the app with the JavaScript Vite template instead of TypeScript, use src/App.jsx and keep the same component structure with JSX syntax.

Add theme styles

Themes for Syncfusion® Gantt Chart component can be applied using CSS files provided through npm theme packages. For available themes, refer to the Themes documentation.

Install the Tailwind 3 theme package using the following command:

npm install @syncfusion/ej2-tailwind3-theme --save

Then add the following CSS reference to the src/App.css file:

@import "../node_modules/@syncfusion/ej2-tailwind3-theme/styles/gantt/index.css";

Create sample data

Define a simple task list with hierarchical relationships. Each task must have a StartDate and either a Duration or EndDate to render properly. If both are provided, EndDate takes precedence. The Duration value is in working days; EndDate is an absolute calendar date.

const taskData = [
  { TaskID: 1, TaskName: 'Project initiation', StartDate: new Date('2024-04-01'), EndDate: new Date('2024-04-15') },
  { TaskID: 2, TaskName: 'Identify site location', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 70, ParentID: 1 },
  { TaskID: 3, TaskName: 'Perform site survey', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 50, ParentID: 1 },
  { TaskID: 4, TaskName: 'Soil testing', StartDate: new Date('2024-04-01'), Duration: 3, Progress: 40, ParentID: 1 },
  { TaskID: 5, TaskName: 'Project estimation', StartDate: new Date('2024-04-15'), EndDate: new Date('2024-04-25') },
  { TaskID: 6, TaskName: 'Develop floor plan', StartDate: new Date('2024-04-15'), Duration: 5, Progress: 30, ParentID: 5 },
  { TaskID: 7, TaskName: 'Estimate project cost', StartDate: new Date('2024-04-15'), Duration: 5, Progress: 20, ParentID: 5 }
];

Configure task fields

Map your data fields to Gantt Chart properties using taskFields:

const taskFields = {
  id: 'TaskID',
  name: 'TaskName',
  startDate: 'StartDate',
  endDate: 'EndDate',
  duration: 'Duration',
  progress: 'Progress',
  parentID: 'ParentID'
};

Field mapping reference

Property Description Required
id Unique task identifier Yes
name Task display name Yes
startDate Task start date Yes
duration Task duration in working days (numeric, optional decimal) No (use endDate instead)
endDate Task end date No (use duration instead)
progress Task completion percentage (0–100) No
parentID Parent task ID for hierarchy No
dependency Predecessor relationships (e.g., 2FS+1d) No
hasChildMapping Indicates whether a row has child rows (load-on-demand) No
resourceInfo Field name that holds resource data No

Render the Gantt Chart component

Put it all together in src/App.tsx. The taskData and taskFields variables defined earlier are reused here.

import { GanttComponent } from '@syncfusion/ej2-react-gantt';
import './App.css';

const taskData = [
  { TaskID: 1, TaskName: 'Project initiation', StartDate: new Date('2024-04-01'), EndDate: new Date('2024-04-15') },
  { TaskID: 2, TaskName: 'Identify site location', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 70, ParentID: 1 },
  { TaskID: 3, TaskName: 'Perform site survey', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 50, ParentID: 1 },
  { TaskID: 4, TaskName: 'Soil testing', StartDate: new Date('2024-04-01'), Duration: 3, Progress: 40, ParentID: 1 },
  { TaskID: 5, TaskName: 'Project estimation', StartDate: new Date('2024-04-15'), EndDate: new Date('2024-04-25') },
  { TaskID: 6, TaskName: 'Develop floor plan', StartDate: new Date('2024-04-15'), Duration: 5, Progress: 30, ParentID: 5 },
  { TaskID: 7, TaskName: 'Estimate project cost', StartDate: new Date('2024-04-15'), Duration: 5, Progress: 20, ParentID: 5 }
];

const taskFields = {
  id: 'TaskID',
  name: 'TaskName',
  startDate: 'StartDate',
  endDate: 'EndDate',
  duration: 'Duration',
  progress: 'Progress',
  parentID: 'ParentID'
};

export default function App() {
  return (
    <GanttComponent
      dataSource={taskData}
      taskFields={taskFields}
      height="450px"
    />
  );
}

Run the application

npm run dev

Access the running application through your configured development URL (Vite default: http://localhost:5173).

Output

You will see a Gantt Chart with:

  • Task hierarchy with parent-child relationships
  • Timeline view showing task bars
  • Progress indicators on each task
  • Automatically calculated dates based on duration

The chart displays two parent tasks (“Project initiation” and “Project estimation”) with their subtasks shown in a tree structure. Task bars are rendered on the timeline, sized according to their duration and start dates.

You can preview the following sample by clicking the Preview Sample button.

import * as React from 'react';
import * as ReactDOM from 'react-dom';
import { GanttComponent } from '@syncfusion/ej2-react-gantt';

const data = [
    { TaskID: 1, TaskName: 'Project initiation', StartDate: new Date('2024-04-01'), EndDate: new Date('2024-04-15') },
    { TaskID: 2, TaskName: 'Identify site location', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 70, ParentID: 1 },
    { TaskID: 3, TaskName: 'Perform site survey', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 50, ParentID: 1 },
    { TaskID: 4, TaskName: 'Soil testing', StartDate: new Date('2024-04-01'), Duration: 3, Progress: 40, ParentID: 1 },
    { TaskID: 5, TaskName: 'Project estimation', StartDate: new Date('2024-04-08'), EndDate: new Date('2024-04-18') },
    { TaskID: 6, TaskName: 'Develop floor plan', StartDate: new Date('2024-04-08'), Duration: 5, Progress: 30, ParentID: 5 },
    { TaskID: 7, TaskName: 'Estimate project cost', StartDate: new Date('2024-04-08'), Duration: 5, Progress: 20, ParentID: 5 }
];

const taskFields = {
    id: 'TaskID',
    name: 'TaskName',
    startDate: 'StartDate',
    duration: 'Duration',
    progress: 'Progress',
    parentID: 'ParentID'
};

export default function App() {
    return <GanttComponent dataSource={data} taskFields={taskFields} height="400px" />;
}

ReactDOM.render(<App />, document.getElementById('root'));
import * as React from 'react';
import * as ReactDOM from 'react-dom';

import { GanttComponent } from '@syncfusion/ej2-react-gantt';

const data: object[] = [
    { TaskID: 1, TaskName: 'Project initiation', StartDate: new Date('2024-04-01'), EndDate: new Date('2024-04-15') },
    { TaskID: 2, TaskName: 'Identify site location', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 70, ParentID: 1 },
    { TaskID: 3, TaskName: 'Perform site survey', StartDate: new Date('2024-04-01'), Duration: 4, Progress: 50, ParentID: 1 },
    { TaskID: 4, TaskName: 'Soil testing', StartDate: new Date('2024-04-01'), Duration: 3, Progress: 40, ParentID: 1 },
    { TaskID: 5, TaskName: 'Project estimation', StartDate: new Date('2024-04-08'), EndDate: new Date('2024-04-18') },
    { TaskID: 6, TaskName: 'Develop floor plan', StartDate: new Date('2024-04-08'), Duration: 5, Progress: 30, ParentID: 5 },
    { TaskID: 7, TaskName: 'Estimate project cost', StartDate: new Date('2024-04-08'), Duration: 5, Progress: 20, ParentID: 5 }
];

const taskFields: any = {
    id: 'TaskID',
    name: 'TaskName',
    startDate: 'StartDate',
    duration: 'Duration',
    progress: 'Progress',
    parentID: 'ParentID'
};

export default function App() {
    return <GanttComponent dataSource={data} taskFields={taskFields} height="400px" />;
};

ReactDOM.render(<App />, document.getElementById('root'));

Troubleshooting

  • License warning in console: Register a valid Syncfusion license key using registerLicense from @syncfusion/ej2-base. You can obtain a key from your Syncfusion account.
  • Styles not applied: Verify the CSS @import paths resolve from src/. With Vite, prefer importing CSS in src/main.tsx if @import inside CSS fails.
  • Peer dependency errors: Ensure React 18+ is installed (npm install react@18 react-dom@18).
  • TypeScript errors on task data: Define an interface for your task records, e.g. interface ITask { TaskID: number; TaskName: string; StartDate: Date; Duration?: number; EndDate?: Date; Progress?: number; ParentID?: number; }.
