Predecessor Validation for Task Dependencies in Blazor Gantt Chart
By default, Gantt task date values are validated based on predecessor values. Enable or disable this validation using the EnablePredecessorValidation property. By default, EnablePredecessorValidation is true.
@using Syncfusion.Blazor.Gantt
<SfGantt @ref="Gantt" DataSource="@TaskCollection" Height="450px" Width="1000px" ProjectStartDate="ProjectStart" ProjectEndDate="ProjectEnd"
Toolbar="@(new List<string>() { "Add", "Edit", "Update", "Cancel"})" EnablePredecessorValidation="false">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate"
Duration="Duration" Dependency="Predecessor" ParentID="ParentId"></GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" AllowAdding="true"></GanttEditSettings>
</SfGantt>
@code {
public SfGantt<TaskData>? Gantt;
private DateTime ProjectStart = new DateTime(2026, 03, 31);
private DateTime ProjectEnd = new DateTime(2026, 07, 06);
private List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public string? Duration { get; set; }
public string? Predecessor { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 06)},
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 1},
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 06), Duration = "3", Progress = 40, Predecessor = "2fs", ParentId = 1 },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 06), Duration = "1", Progress = 30, ParentId = 1 },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 07) },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 30, ParentId = 5 },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 40, Predecessor = "6", ParentId = 5 },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 04, 07), Duration = "2", Progress = 30, ParentId = 5 }
};
return Tasks;
}

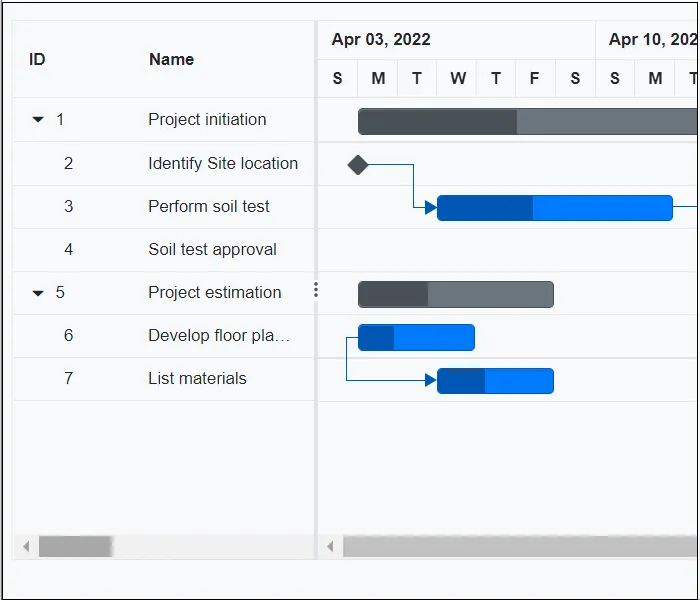

}Custom validation using TaskbarEditing event
In Blazor Gantt Chart, the task relationship link can be broken by editing the start date, end date, or duration of a task. When the task relationship is broken during any edit action, it can be handled in Blazor Gantt Chart in the following ways.
Validation mode
When editing tasks with predecessor links, the TaskbarEditing event is triggered. You can validate the editing action within the TaskbarEditing event using the ValidateMode event argument. The ValidateMode argument provides the following properties:
| Argument | Default value | Description |
|---|---|---|
| args.ValidationMode.RespectLink | false | In this validation mode, the predecessor links get high priority. For example, in FS type, with this mode enabled, when the successor task is moved before the predecessor task’s end date, the editing will be reverted, and dates will be validated based on the dependency links. |
| args.ValidationMode.PreserveLinkWithEditing | true | In this validation mode, the taskbar editing will be considered along with the dependency links. This relationship will be maintained by updating the offset value of predecessors. |
By default, the PreserveLinkWithEditing validation mode is enabled, so the predecessors are updated with offset values.

The following code example explains enabling the RespectLink validation mode while editing the linked tasks in the TaskbarEditing event.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="700px">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress"
Dependency="Predecessor" ParentID="ParentId"></GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing></GanttEditSettings>
<GanttEvents TValue="TaskData" TaskbarEditing="TaskbarEditing"></GanttEvents>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public void TaskbarEditing(TaskbarEditingEventArgs<TaskData> args)
{
if (args.ValidationMode != null)
{
args.ValidationMode.RespectLink = true;
}
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public string? Predecessor { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 06)},
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 1},
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 06), Duration = "3", Progress = 40, Predecessor = "2fs", ParentId = 1 },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 06), Duration = "1", Progress = 30, ParentId = 1 },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 07) },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 30, ParentId = 5 },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 40, Predecessor = "6", ParentId = 5 },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 04, 07), Duration = "2", Progress = 30, ParentId = 5 }
};
return Tasks;
}
}Predecessor offset validation
In Gantt the AutoUpdatePredecessorOffset property is used to control whether predecessor offsets are recalculated automatically during task scheduling. When AutoUpdatePredecessorOffset is true (the default), the Gantt component recalculates and updates predecessor offsets whenever task edited that affect scheduling—such as start date, end date, duration, or dependencies—are changed. When set to false, offsets are not recalculated; the Gantt uses the offset values supplied by the data source, allowing offsets to be managed externally or preserved as predefined values. In cases where a task has multiple predecessors, the highest offset value among its predecessors is used and existing offset values from the data source are retained without modification.
The taskbar can be moved above the specified predecessor offset value, but if it is dragged below the offset value, it will revert to the minimum predecessor value.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="1000px" ProjectStartDate="ProjectStart" ProjectEndDate="ProjectEnd"
Toolbar="@(new List<string>() { "Add", "Edit", "Update", "Cancel" })" AutoUpdatePredecessorOffset="false">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate"
Duration="Duration" Dependency="Predecessor" ParentID="ParentId"></GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" AllowAdding="true"></GanttEditSettings>
</SfGantt>
@code {
private DateTime ProjectStart = new DateTime(2026, 03, 31);
private DateTime ProjectEnd = new DateTime(2026, 07, 06);
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public string? Duration { get; set; }
public string? Predecessor { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 06)},
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 1},
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 06), Duration = "3", Progress = 40, Predecessor = "2fs", ParentId = 1 },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 06), Duration = "1", Progress = 30, ParentId = 1 },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 07) },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 30, ParentId = 5 },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 40, Predecessor = "6", ParentId = 5 },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 04, 07), Duration = "2", Progress = 30, ParentId = 5 }
};
return Tasks;
}
}When
EnablePredecessorOffsetValidationis enabled, the predecessor offset will not be updated on dragging the taskbar. You can update the predecessor offset either by cell edit or dialog edit.
Auto-link validation
When connector lines are drawn between tasks, the task dates are validated based on predecessor values. You can restrict this validation when drawing predecessors using the TaskbarEditing event. You can enable or disable the validation using the EnablePredecessorValidation event argument. By default, EnablePredecessorValidation is true.
In the following code example, the connector line connected from task ID 2 to task ID 3 is rendered at load time, so validation occurs. However, the connector line from task ID 6 to task ID 7 is drawn dynamically, and validation is restricted by disabling the EnablePredecessorValidation property.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="1000px" Toolbar="@(new List<string>() { "Add", "Edit", "Update", "Cancel" })">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate"
Duration="Duration" Dependency="Predecessor" ParentID="ParentId"></GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" AllowAdding="true"></GanttEditSettings>
<GanttEvents TaskbarEditing="TaskbarEditingHandler" TValue="TaskData"></GanttEvents>
</SfGantt>
@code {
private DateTime ProjectStart = new DateTime(2026, 3, 24);
private DateTime ProjectEnd = new DateTime(2026, 7, 6);
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public void TaskbarEditingHandler(TaskbarEditingEventArgs<TaskData> args)
{
args.EnablePredecessorValidation = true;
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public string? Duration { get; set; }
public string? Predecessor { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 06)},
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 1},
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 06), Duration = "3", Progress = 40, Predecessor = "2fs", ParentId = 1 },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 06), Duration = "1", Progress = 30, ParentId = 1 },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 07) },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 30, ParentId = 5 },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 07), Duration = "3", Progress = 40, Predecessor = "6", ParentId = 5 },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 04, 07), Duration = "2", Progress = 30, ParentId = 5 }
};
return Tasks;
}
}EnablePredecessorValidation API is used to enable/disable validation based on predecessor values both on load time and on edit actions like cell editing, dialog editing, and on predecessor drawing. Whereas, EnablePredecessorValidation event argument is used to enable/disable validation only on predecessor drawing.
