Managing Tasks with Add, Edit, and Delete in Blazor Gantt Chart
Managing tasks in the Blazor Gantt Chart component enables dynamic project updates, such as inserting, deleting, or editing tasks and dependencies, by enabling AllowAdding, AllowDeleting, AllowEditing, and AllowTaskbarEditing. A primary key column, defined by GanttColumn.IsPrimaryKey set to true (e.g., on id), ensures reliable CRUD operations and task identification. Editing modes include cell editing for quick TreeGrid updates, dialog editing for comprehensive changes, taskbar dragging for duration or date adjustments, and connector line dragging for dependencies. Customize dialogs with templates or fields using AddDialogFields and EditDialogFields. Methods like AddRecordAsync, DeleteRecordAsync, and UpdateRecordByIDAsync support programmatic management. Ensure valid GanttTaskFields mappings and a primary key to enable editing seamlessly.
The following code example demonstrates editing in the Gantt component.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="700px">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress" ParentID="ParentId" Dependency="Predecessor">
</GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" Mode="Syncfusion.Blazor.Gantt.EditMode.Auto"></GanttEditSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public string ?Predecessor { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>();
Tasks.Add(new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 06), EndDate = new DateTime(2026, 04, 09), });
Tasks.Add(new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 06), Duration = "0", Progress = 30, ParentId = 1 });
Tasks.Add(new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 06), EndDate = new DateTime(2026, 04, 09), Progress = 40, Predecessor = "2", ParentId = 1 });
Tasks.Add(new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 06), Duration = "0", Progress = 30, Predecessor = "3", ParentId = 1 });
Tasks.Add(new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 11), EndDate = new DateTime(2026, 04, 18), });
Tasks.Add(new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 06), EndDate = new DateTime(2026, 04, 09), Progress = 30, Predecessor = "4", ParentId = 5 });
Tasks.Add(new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 06), EndDate = new DateTime(2026, 04, 09), Progress = 40, Predecessor = "6", ParentId = 5 });
Tasks.Add(new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 04, 06), Duration = "0", Progress = 30, Predecessor = "7", ParentId = 5 });
return Tasks;
}
}Editing feature requires a primary key column for CRUD operations. When defining columns in Gantt using the GanttColumns property, at least one column must be marked as the primary key. By default, the Id column will be the primary key column. If Id column is not defined, we need to enable IsPrimaryKey for any one of the columns defined in the GanttColumns property.
Cell edit type and its params
The GanttColumn.EditType is used to define the edit type for any particular column. You can set the GanttColumn.EditType based on data type of the column.
Below is the combined content from the provided markdown sections in bullet points, as requested, ensuring clarity and conciseness while preserving the original information:
-
Cell edit types and components:
- numericedit: Uses the NumericTextBox component for editing integers, doubles, and decimals.
- defaultedit: Uses the TextBox component for editing string data.
- dropdownedit: Uses the DropDownList component to display all unique values for a field.
- booleanedit: Uses the Checkbox component for editing boolean data.
- datepickeredit: Uses the DatePicker component for editing date data.
- datetimepickeredit: Uses the DateTimePicker component for editing date-time data.
-
Customization:
- You can customize model of the
GanttColumn.EditTypecomponent through the GanttColumn.EditorSettings.
- You can customize model of the
-
Edit type parameters:
-
numericedit: Supports parameters like
Decimals: 2,Value: 5. -
dropdownedit: Supports parameters like
Value: 'Germany'. -
booleanedit: Supports parameters like
Checked: true. -
datepickeredit: Supports parameters like
Format: 'dd.MM.yyyy'. -
datetimepickeredit: Supports parameters like
Value: new Date().
-
numericedit: Supports parameters like
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="900px" Toolbar="@(new List<string>() { "Add", "Edit", "Delete", "Update", "Cancel" })">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress" ParentID="ParentId">
</GanttTaskFields>
<GanttColumns>
<GanttColumn Field="TaskId" Width="100"></GanttColumn>
<GanttColumn Field="TaskName" Width="250"></GanttColumn>
<GanttColumn Field="StartDate" EditorSettings="DateParams" Type="Syncfusion.Blazor.Grids.ColumnType.DateTime" EditType="Syncfusion.Blazor.Grids.EditType.DateTimePickerEdit"></GanttColumn>
<GanttColumn Field="Duration"></GanttColumn>
<GanttColumn Field="Progress" EditorSettings="NumericParams" EditType="Syncfusion.Blazor.Grids.EditType.NumericEdit"></GanttColumn>
</GanttColumns>
<GanttEditSettings AllowEditing="true" AllowAdding="true"></GanttEditSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
public Syncfusion.Blazor.Grids.NumericEditCellParams NumericParams = new Syncfusion.Blazor.Grids.NumericEditCellParams()
{
Params = new Syncfusion.Blazor.Inputs.NumericTextBoxModel<object>() { Format = "N2" }
};
public Syncfusion.Blazor.Grids.DateEditCellParams DateParams = new Syncfusion.Blazor.Grids.DateEditCellParams()
{
Params = new Syncfusion.Blazor.Calendars.DatePickerModel() { Format = "d" }
};
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>()
{
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), },
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), Progress = 40, ParentId = 1, },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 10), },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 30, ParentId = 5, },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 40, ParentId = 5, },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 01, 07), Duration = "0", Progress = 30, ParentId = 5, }
};
return Tasks;
}
}If edit type is not defined in the column, then it will be considered as the StringEdit type (Textbox component).
Cell edit template
The cell EditTemplate feature in Syncfusion Blazor Gantt Chart component allows you to customize the editing interface of individual cell by embedding custom components or HTML elements. Instead of using the default editor such as a textbox, you can define a template that provides a tailored editing experience such as a dropdown, date picker, or checkbox based on your application’s requirements. This is especially useful when you need more control over how data is entered or displayed during editing.
The following code example demonstrates how to define an edit template for a specific column, where the TaskName field is rendered using a dropdown.
@using Syncfusion.Blazor.Gantt
@using Syncfusion.Blazor.Grids
@using Syncfusion.Blazor.DropDowns;
<SfGantt DataSource="@TaskCollection" Height="450px" Width="700px" Toolbar="@(new List<string>() { "Add", "Cancel", "Edit", "Update", })">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress" ParentID="ParentId">
</GanttTaskFields>
<GanttColumns>
<GanttColumn Field="TaskId" IsPrimaryKey=true></GanttColumn>
<GanttColumn Field="TaskName">
<EditTemplate>
@{
var task = (context as TaskData);
}
<SfDropDownList @ref="dropdown" Placeholder="Name" FloatLabelType="Syncfusion.Blazor.Inputs.FloatLabelType.Always" ID="TaskName" @bind-Value="task.TaskName" TItem="string" TValue="string" DataSource="@DropDownData">
</SfDropDownList>
</EditTemplate>
</GanttColumn>
<GanttColumn Field="Duration"></GanttColumn>
<GanttColumn Field="StartDate"></GanttColumn>
<GanttColumn Field="Progress"></GanttColumn>
</GanttColumns>
<GanttEditSettings AllowAdding="true" AllowEditing=true AllowTaskbarEditing=true></GanttEditSettings>
<GanttEvents OnCellSave="CellSaveHandler" TValue="TaskData"></GanttEvents>
</SfGantt>
@code {
SfDropDownList<string, string>? dropdown;
private void CellSaveHandler(CellSaveArgs<TaskData> args)
{
if (args.ColumnName == "TaskName")
{
args.Value = dropdown?.Value;
}
}
public List<TaskData>? TaskCollection { get; set; }
private List<string>? DropDownData { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
DropDownData = TaskCollection
.Select(s => s.TaskName ?? string.Empty)
.Distinct()
.ToList();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>()
{
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), },
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), Progress = 40, ParentId = 1, },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 10), },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 30, ParentId = 5, },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 40, ParentId = 5, },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 01, 07), Duration = "0", Progress = 30, ParentId = 5, }
};
return Tasks;
}
}Disable editing for particular column
You can disable editing for particular columns, by using the GanttColumn.AllowEditing property.
In the following demo, editing is disabled for the TaskName column.
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="900px" Toolbar="@(new List<string>() { "Edit" })">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress" ParentID="ParentId">
</GanttTaskFields>
<GanttColumns>
<GanttColumn Field="TaskId" Width="100"></GanttColumn>
<GanttColumn Field="TaskName" Width="250" AllowEditing="false"></GanttColumn>
<GanttColumn Field="StartDate"></GanttColumn>
<GanttColumn Field="Duration"></GanttColumn>
<GanttColumn Field="Progress"></GanttColumn>
</GanttColumns>
<GanttEditSettings AllowEditing="true"></GanttEditSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime? EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>()
{
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), },
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), Progress = 40, ParentId = 1, },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 10), },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 30, ParentId = 5, },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 40, ParentId = 5, },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 01, 07), Duration = "0", Progress = 30, ParentId = 5, }
};
return Tasks;
}
}Troubleshoot: Editing works only when primary key column is defined
The editing feature in the Syncfusion Blazor Gantt Chart component requires a primary key column to perform CRUD operations. When defining columns using the GanttColumns property, at least one column must be marked as the primary key.
By default, the Id column is considered the primary key. If the Id column is not defined, you must explicitly set the IsPrimaryKey property to true for one of the columns in the GanttColumns collection to enable editing functionality.
Touch interaction
The Blazor Gantt Chart component editing actions can be achieved using the double tap and tap and drag actions on an element.
The following table describes different types of editing modes available in Gantt.
| Action | Description |
|---|---|
| Cell editing | To perform double tap on a specific cell, initiate the cell to be in edit state. |
| Dialog editing | To perform double tap on a specific row, initiate the edit dialog to be opened. |
| Taskbar editing | Taskbar editing action is initiated using the tap action on the taskbar. Parent taskbar : Once you tap on the parent taskbar, it will be changed to editing state. Perform only dragging action on parent taskbar editing. Child taskbar : Once you tap the child taskbar, it will be changed to editing state. Dragging taskbar : To drag a taskbar to the left or right in editing state. Resizing taskbar : To resize a taskbar, drag the left/right resize icon. Progress resizing : To change the progress, drag the progress resize icon to the left or right direction. |

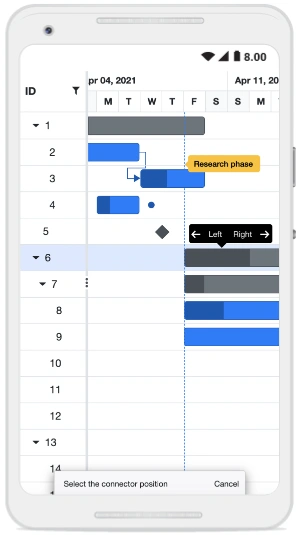

Task dependency editing
You can tap the left/right connector point to initiate task dependencies edit mode and again tap another taskbar to establish the dependency line between two taskbars.
Once the dependency edit mode is initiated, a dialog appears with the message Choose another task and a Cancel button. Tapping another taskbar will prompt a second dialog with the message Select the connector position and a tooltip near the second taskbar showing Left and Right buttons. Selecting one of these buttons establishes the dependency relationship between the two tasks. You can click the Cancel button at any time to exit the edit mode.

The following table explains the taskbar state in dependency edit mode.
| Taskbar state | Description |
|---|---|
| Parent taskbar | You cannot create dependency relationship to parent tasks.
|
| Taskbar without dependency | If you tap a valid child taskbar, it will create FS type dependency line between tasks, otherwise exits from task dependency edit mode.
|
| Taskbar with dependency | If you tap the second taskbar, which has already been directly connected, it will ask to remove it.
|
| Removing dependency | Once you tap the taskbar with direct dependency, then confirmation dialog will be shown for removing dependency.
|
Taskbar editing tooltip
The taskbar editing tooltip can be integrated in Blazor Gantt Chart by using the GanttTooltipSettings.ShowTooltipOnEditing property. By default, this property is set to true. The following code example shows how to integrate the GanttTooltipSettings.ShowTooltipOnEditing in a Blazor Gantt Chart:
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="900px" TreeColumnIndex="1"
Toolbar="@(new List<string>() { "Add", "Cancel", "CollapseAll", "Delete", "Edit", "ExpandAll", "Search", "Update" , "Indent" , "Outdent"})">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate"
Duration="Duration" Progress="Progress" Dependency="Predecessor" ParentID="ParentId" Notes="Notes">
</GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" AllowAdding="true" AllowDeleting="true">
</GanttEditSettings>
<GanttTooltipSettings ShowTooltipOnEditing="true" TValue="TaskData"></GanttTooltipSettings>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public string? Predecessor { get; set; }
public string? Notes { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 04, 02), EndDate = new DateTime(2026, 04, 10)},
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 04, 02), EndDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 1 },
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 04, 02), EndDate = new DateTime(2026, 04, 06), Progress = 40, Predecessor = "2FS", ParentId = 1 },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 04, 02), Duration = "0", Progress = 30, Predecessor = "3FF", ParentId = 1 },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 04, 03), EndDate = new DateTime(2026, 04, 08)},
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 04, 03), EndDate = new DateTime(2026, 04, 06), Progress = 30, ParentId = 5 },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 04, 03), EndDate = new DateTime(2026, 04, 06), Progress = 40, Predecessor = "6SS", ParentId = 5 }
};
return Tasks;
}
}Template
The taskbar editing tooltip can be customized using the GanttTooltipSettings.EditingTemplate property. The following code example shows how to customize the taskbar editing tooltip in a Blazor Gantt Chart:
@using Syncfusion.Blazor.Gantt
<SfGantt DataSource="@TaskCollection" Height="450px" Width="700px">
<GanttTaskFields Id="TaskId" Name="TaskName" StartDate="StartDate" EndDate="EndDate" Duration="Duration" Progress="Progress" ParentID="ParentId"></GanttTaskFields>
<GanttEditSettings AllowTaskbarEditing="true" AllowEditing="true" AllowAdding="true"
AllowDeleting="true" ShowDeleteConfirmDialog="true">
</GanttEditSettings>
<GanttTooltipSettings ShowTooltip="true" TValue="TaskData">
<EditingTemplate>
<table>
@{
var template = (context as TaskData);
if (TaskbarEditAction == "LeftResizing")
{
<tr> <td style="padding:3px">@(template.StartDate.ToString("MMM dd, yyyy"))</td> </tr>
<tr> <td style="padding:6px">@(template.Duration) days</td> </tr>
}
else if (TaskbarEditAction == "RightResizing")
{
<tr> <td style="padding:3px">@(template.EndDate.ToString("MMM dd, yyyy"))</td> </tr>
<tr> <td style="padding:6px">@(template.Duration) days</td> </tr>
}
else if (TaskbarEditAction == "ChildDrag" || TaskbarEditAction == "ParentDrag" || TaskbarEditAction == "MilestoneDrag")
{
<tr> <td style="padding:3px">@(template.StartDate.ToString("MMM dd, yyyy"))</td> </tr>
<tr> <td style="padding:3px">@(template.EndDate.ToString("MMM dd, yyyy"))</td> </tr>
}
else if (TaskbarEditAction == "ProgressResizing")
{
<tr> <td style="padding:3px">@(template.Progress) %</td> </tr>
}
}
</table>
</EditingTemplate>
</GanttTooltipSettings>
<GanttEvents TaskbarEditing="TaskbarEditingHandler" TValue="TaskData"></GanttEvents>
</SfGantt>
@code {
public List<TaskData>? TaskCollection { get; set; }
private string? TaskbarEditAction { get; set; }
private void TaskbarEditingHandler(TaskbarEditingEventArgs<TaskData> args)
{
TaskbarEditAction = args.Action;
}
protected override void OnInitialized()
{
TaskCollection = GetTaskCollection();
}
public class TaskData
{
public int TaskId { get; set; }
public string? TaskName { get; set; }
public DateTime StartDate { get; set; }
public DateTime EndDate { get; set; }
public string? Duration { get; set; }
public int Progress { get; set; }
public int? ParentId { get; set; }
}
public static List<TaskData> GetTaskCollection()
{
List<TaskData> Tasks = new List<TaskData>() {
new TaskData() { TaskId = 1, TaskName = "Project initiation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), },
new TaskData() { TaskId = 2, TaskName = "Identify Site location", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 3, TaskName = "Perform soil test", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 08), Progress = 40, ParentId = 1, },
new TaskData() { TaskId = 4, TaskName = "Soil test approval", StartDate = new DateTime(2026, 01, 05), Duration = "0", Progress = 30, ParentId = 1, },
new TaskData() { TaskId = 5, TaskName = "Project estimation", StartDate = new DateTime(2026, 01, 05), EndDate = new DateTime(2026, 01, 10), },
new TaskData() { TaskId = 6, TaskName = "Develop floor plan for estimation", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 30, ParentId = 5, },
new TaskData() { TaskId = 7, TaskName = "List materials", StartDate = new DateTime(2026, 01, 07), EndDate = new DateTime(2026, 01, 09), Progress = 40, ParentId = 5, },
new TaskData() { TaskId = 8, TaskName = "Estimation approval", StartDate = new DateTime(2026, 01, 07), Duration = "0", Progress = 30, ParentId = 5, }
};
return Tasks;
}
}
